How to Audit a Steel Shelving Manufacturer in China | KAYOU


How to Audit a Steel Shelving Manufacturer in China: A Practical Guide for B2B Buyers

To audit a steel shelving manufacturer in China, verify the legal company first, then trace one actual shelving model from its approved drawing and bill of materials through raw steel, forming, welding, coating, assembly, load evidence, final inspection and export packaging. Judge the supplier by consistent, model-specific records and measurements—not by certificates, showroom samples or factory size alone.

For importers, distributors and warehouse project buyers, a factory audit is not simply a tour of machines. Its purpose is to answer four commercial questions:

  1. Can this supplier manufacture the exact product it quoted?

  2. Can it repeat the same specification throughout mass production?

  3. Can it prove the stated load capacity and finish quality?

  4. Can it deliver the correct quantity, packaging and documents on time?

This guide focuses on medium duty shelving, long span shelving, boltless steel shelving and other hand-loaded industrial shelving. Pallet racking, cantilever racking and mezzanine structures require additional project-specific engineering and may fall under different standards.

B2B buyer auditing a steel shelving manufacturer in China

Why a Steel Shelving Factory Audit Matters

Two shelving quotations can show the same outside dimensions, number of levels and advertised load, yet describe very different products.

The differences may be hidden in:

  • Upright profile and developed section size

  • Actual steel thickness after forming

  • Beam height, geometry and connector design

  • Shelf-panel thickness and reinforcement

  • Clear beam span

  • Number and spacing of shelf levels

  • Bracing arrangement

  • Steel grade and material consistency

  • Pretreatment and powder-coating process

  • Load distribution used for rating

  • Packaging protection and loading quantity

A small reduction in thickness or reinforcement may lower price and shipping weight, but it can also change stiffness, deflection, stability and service life. That is why a professional audit compares the supplier's sales specification with physical components, controlled records and repeatable test evidence.

Start with a Fixed Technical Specification

Do not audit a vague product such as “a five-tier heavy duty shelf.” Before the audit, issue a controlled specification or request that the supplier prepare one for approval.

At minimum, confirm:

ItemInformation to Fix Before the Audit
Product typeBoltless shelving, long span shelving, steel-panel shelving or another defined system
Overall sizeLength × depth × height in mm and inches
Clear dimensionsClear shelf width, usable depth and clear height between levels
Shelf levelsNumber, position and adjustment pitch
Rated loadkg per level, stated as UDL or another clearly defined loading condition
Total bay loadMaximum permitted merchandise load for the complete bay
Main sectionsUpright, beam, bracing and shelf-panel profiles and thicknesses
DeckingSteel panels, wire mesh, plywood or another approved material
Surface finishPowder type, color/RAL, pretreatment and required coating criteria
ConfigurationStarter bay, add-on bay, freestanding unit or connected rows
AccessoriesFeet, safety pins, anchors, dividers, back panels, labels and protectors
PackagingCarton/pallet method, pieces per package, marks and drop-protection requirements
DestinationCountry, use environment and any applicable local standard or regulation

The audit is meaningful only when every document, sample and measurement refers to this same configuration.

Use Four Types of Audit Evidence

A reliable finding normally combines four kinds of evidence:

  • Document: drawing, bill of materials, inspection record, material certificate or test report

  • Observation: the process, equipment and operator activity seen in the factory

  • Measurement: thickness, dimensions, coating film, weight, fit or test load checked with suitable equipment

  • Traceability: a batch, component or finished unit connected to its material, process and inspection history

If a claim is supported by only one undated photograph or one generic certificate, it is not yet a strong audit conclusion.

1. Verify the Legal Company and the Real Factory

Begin by confirming who will sign the contract, receive payment, manufacture the goods and appear on export documents.

Request:

  • Chinese business licence with the unified social credit code

  • Registered Chinese company name and English trading name

  • Registered address and actual factory address

  • Bank beneficiary name

  • Export entity or trading-company relationship, if different

  • Factory lease or ownership evidence when relevant to a high-value project

  • Organization chart and key contacts for engineering, production and quality

The Chinese legal name should be checked through China's official National Enterprise Credit Information Publicity System. Compare the legal entity with the name on the contract, bank account, certificates, quotation and test records.

A trading company is not automatically a poor supplier, and a manufacturer may use an affiliated export company. The risk arises when the relationship is hidden or cannot be documented. Ask the supplier to explain the commercial and manufacturing roles clearly.

Warning Signs

  • The supplier refuses to disclose the Chinese legal name.

  • The bank beneficiary is an unrelated company or individual without explanation.

  • The audit address differs from the licence and quotation, but no relationship is documented.

  • The sales team shows a showroom but restricts access to production and inspection areas.

  • Certificates belong to another entity, factory or product scope.

2. Confirm the Product Is Actually Manufactured There

Some factories produce uprights and beams internally but subcontract shelf panels, wire decking, welding or powder coating. Subcontracting is not necessarily unacceptable; undisclosed and uncontrolled subcontracting is the problem.

During the visit, follow the normal production flow:

  1. Raw-material receiving and storage

  2. Slitting or cutting

  3. Roll forming, punching, bending or stamping

  4. Welding where required

  5. Deburring and surface preparation

  6. Powder coating and curing

  7. Assembly and fit check

  8. Final inspection

  9. Packing and finished-goods storage

For each outsourced process, ask:

  • Who performs it?

  • What technical specification is issued?

  • How are incoming subcontracted parts inspected?

  • How are coating, welding or dimensional nonconformities controlled?

  • Can the supplier trace the subcontracted batch to the finished order?

An honest supplier should distinguish its internal capabilities from qualified external processes.

Steel shelving material and thickness verification during factory audit

3. Review the Quality Management System—but Do Not Stop at ISO 9001

ISO 9001 is a quality management system standard. It can show that a company has established controlled processes, responsibilities, records and improvement mechanisms. It does not by itself certify that a particular shelf holds 300 kg, that a coating is corrosion-proof or that every shipment meets your drawing.

If the manufacturer presents an ISO certificate:

  • Check the company name and site address.

  • Check the certificate number, issue date and expiry/status.

  • Read the certification scope; it should be relevant to shelving, racking, metal products or the actual manufacturing activity.

  • Identify the certification body and its accreditation.

  • Validate accredited management-system certificates through the issuing body or IAF CertSearch.

  • Ask to see records created by the system, not only the certificate.

Useful records include:

  • Approved drawings and revision control

  • Supplier approval and incoming inspection

  • Process inspection sheets

  • Equipment calibration records

  • Nonconformity reports

  • Corrective-action records

  • Final inspection and release authorization

  • Customer complaint and improvement records

The objective is to determine whether the quality system changes daily behavior on the shop floor.

4. Evaluate Engineering and Specification Control

A capable steel shelving manufacturer should be able to convert a buyer's storage requirement into a controlled technical configuration.

Ask the engineering team to explain:

  • How the rated load was determined

  • Which dimensions and spans the rating applies to

  • The difference between load per level and total bay load

  • Whether the rating assumes a uniformly distributed load (UDL)

  • How concentrated loads or uneven cartons are handled

  • How main bays and add-on bays affect stability

  • When bracing, wall fixing or floor anchoring is required

  • Which design or test standard applies to the destination market

  • How drawing changes are approved and released to production

For industrial boltless steel shelving in the United States, for example, ANSI MH28.2-2022 covers design, testing and utilization within its defined scope. Industrial bin shelving, retail/consumer boltless shelving, pallet racks and work platforms are addressed separately. A test report for one category should not be presented as universal approval for every storage product.

Review a complete technical file for one current model:

  • General assembly drawing

  • Component drawings

  • Bill of materials (BOM)

  • Steel grade and thickness

  • Critical tolerances

  • Rated load and loading diagram

  • Test method or engineering basis

  • Assembly instructions

  • Safety and SWL/load labels

  • Packaging specification

The drawing number and revision should match the sample, production order and inspection record.

Industrial steel shelving UDL load rating verification

5. Verify Steel Grade, Thickness and Material Traceability

Material verification is one of the most important parts of a shelving audit because small thickness differences may be difficult to see after forming and coating.

Check the Material Documents

Request the mill test certificate (MTC) or material certificate for the relevant steel batch where contractually required. Check:

  • Steel grade

  • Coil or heat/batch number

  • Nominal thickness

  • Mechanical or chemical data where specified

  • Supplier and receiving date

  • Link between the certificate, incoming coil and production order

An MTC is useful only if the supplier can connect it to the material actually used. A generic certificate from a previous purchase does not prove the current batch.

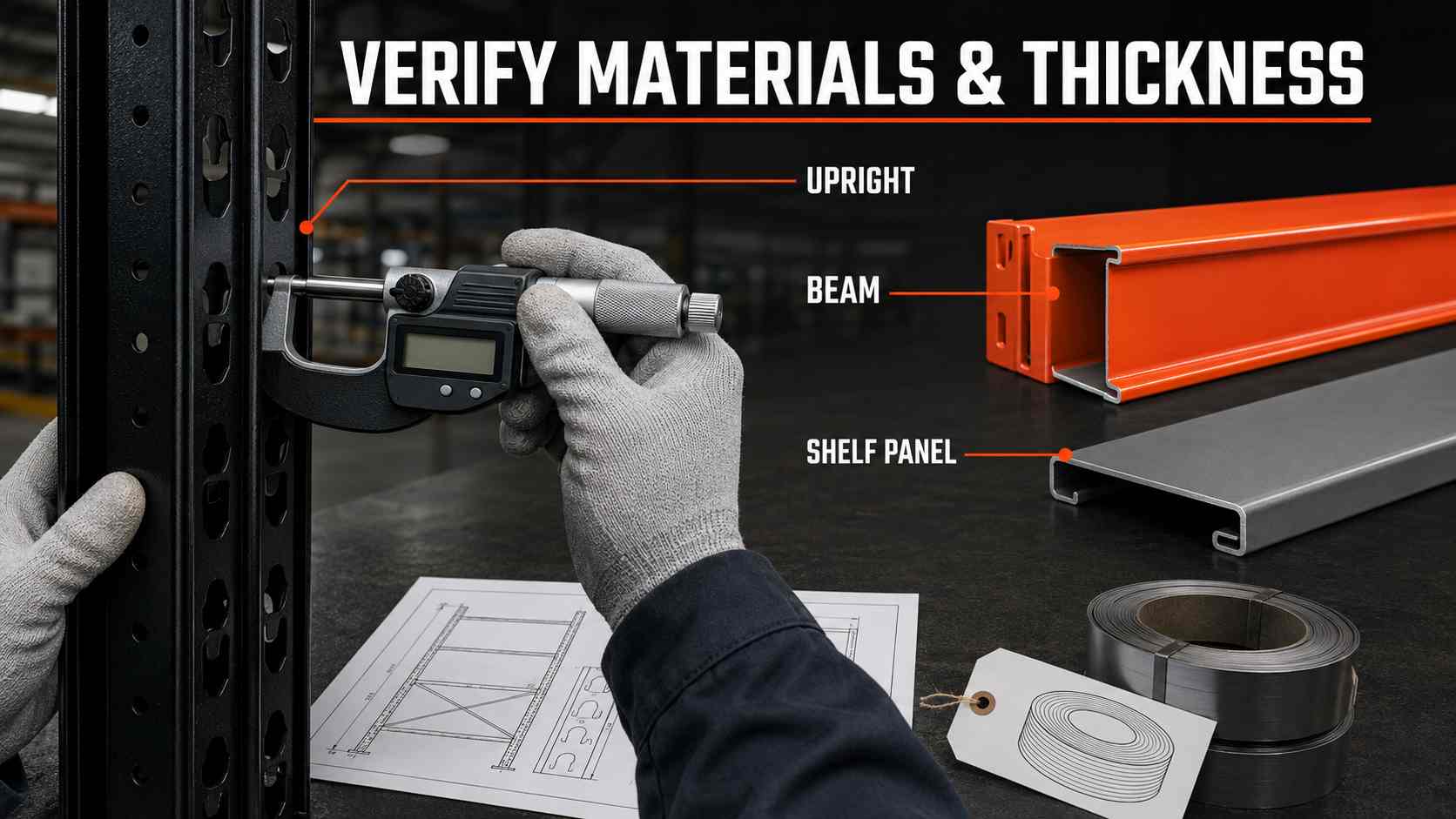

Measure Physical Components

Use a calibrated micrometer or another agreed instrument to measure accessible uncoated material or apply a documented method that accounts for coating. Take several readings on:

  • Uprights

  • Load beams

  • Shelf panels

  • Bracing members

  • Reinforcement channels

  • Connectors and footplates where critical

Record the location and result. Do not compare a single reading with a nominal value without considering the purchase specification and permitted material tolerance.

Also verify:

  • Component weight against the approved BOM

  • Profile geometry and dimensions

  • Hole pattern and adjustment pitch

  • Reinforcement count and placement

  • Weld size and location where applicable

Weight can be a useful cross-check, but it does not replace thickness and profile verification.

6. Inspect Forming, Punching, Welding and Assembly Quality

Walk through production with the approved drawing in hand.

Formed Components

Check for:

  • Consistent profile shape

  • Excessive twisting, bowing or camber

  • Cracks at bends or punched openings

  • Burrs and sharp edges

  • Hole position and pitch

  • Connector geometry

  • Repeatability between components

Welded Components

Where welding is used, check:

  • Weld locations against the drawing

  • Continuity and size where specified

  • Excessive spatter, undercut, burn-through, porosity or missed welds

  • Fixture control and distortion

  • Operator qualification or internal competence records when contractually required

Trial Assembly

Select parts from normal production—not only a prepared showroom sample—and assemble one complete unit. Verify:

  • Components fit without forced correction.

  • Beams and shelf panels seat correctly.

  • Safety locks or connectors engage as intended.

  • The unit stands square and stable.

  • Shelf levels are adjustable at the specified pitch.

  • Starter and add-on bays connect correctly.

  • Required bolts, anchors and accessories are complete.

  • The assembly instructions match the delivered product.

A trial assembly often reveals tolerance, connector and packing-kit problems that individual component inspection may miss.

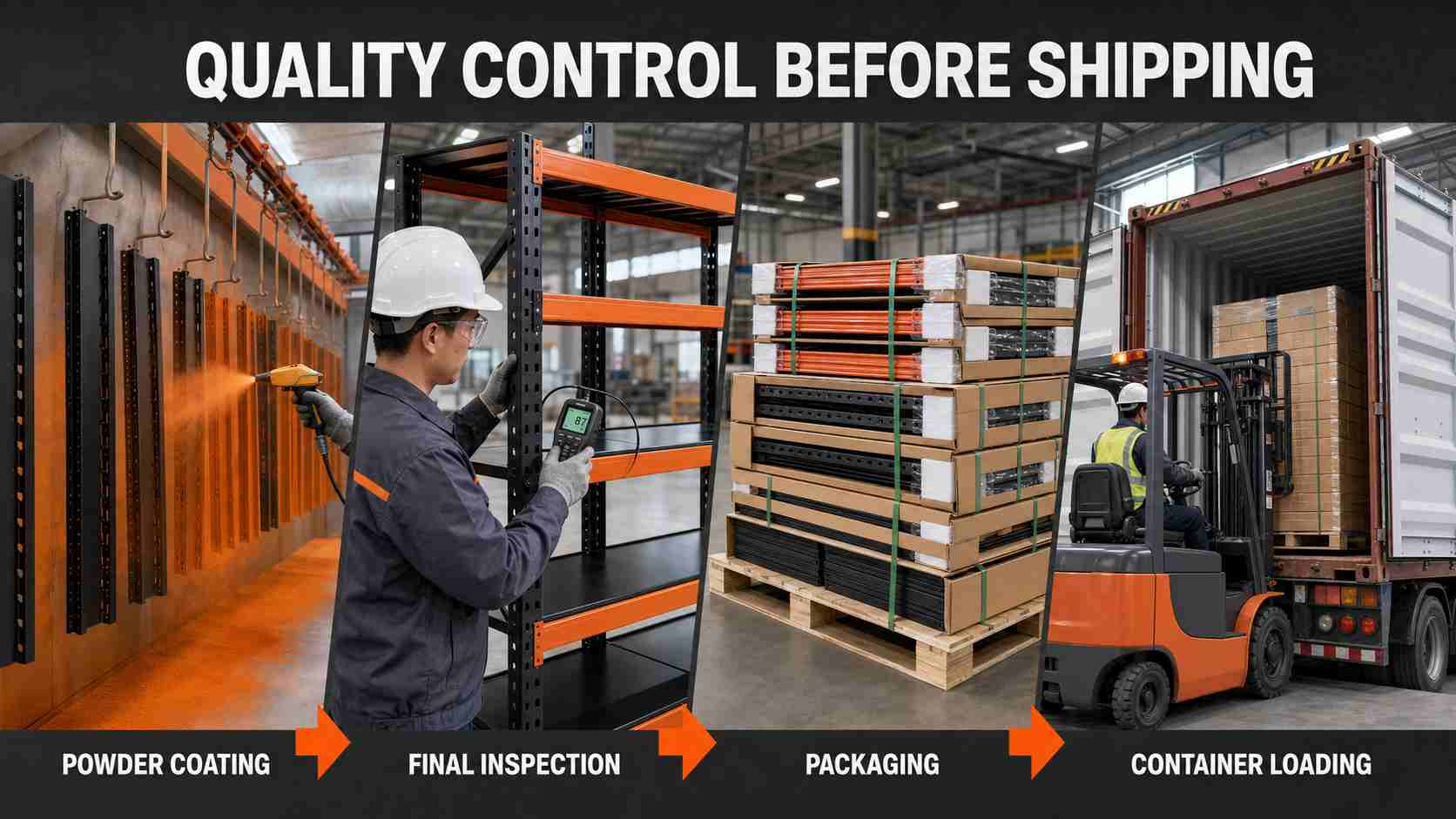

Steel shelving quality control before export shipping

7. Examine Load-Capacity Evidence Carefully

The statement “200 kg per shelf” is incomplete unless it identifies the tested or calculated configuration.

The evidence should state:

  • Product model and drawing revision

  • Overall dimensions

  • Clear beam span and shelf depth

  • Upright and beam profiles and thicknesses

  • Deck type and reinforcement

  • Number and spacing of shelf levels

  • Test load and rated load

  • Load distribution and loading pattern

  • Test duration

  • Measurement points and equipment

  • Deflection or displacement readings

  • Permanent deformation after unloading, where assessed

  • Failure, instability or connection observations

  • Test date, sample identification and responsible party

  • Applicable test method and acceptance criteria

UDL Is Not the Same as a Concentrated Load

A uniformly distributed load spreads weight across the shelf. The same total weight placed in one small area can create higher local stress and deck deformation. Audit the loading diagram as carefully as the kilogram value.

Do Not Accept These as Sufficient Proof

  • A photograph of people standing on a shelf

  • Concrete blocks without verified total weight

  • A report for a different shelf width or beam span

  • A report with no component thicknesses

  • A report for pallet racking used to support a shelving claim

  • A certificate that lists only a product family and no tested model

  • A video that does not show the loading method or measurement results

For a customized or high-volume order, agree on a model-specific test plan before production. If an independent laboratory or third-party inspector is required, define the sampling, witness points and reporting scope in the purchase contract.

8. Audit Powder Coating and Corrosion Protection

A glossy finish does not prove that the surface system is durable. The quality of powder-coated shelving depends on pretreatment, surface cleanliness, powder selection, application, curing and edge coverage.

Check:

  • Degreasing and pretreatment stages

  • Bath concentration, temperature and maintenance records where applicable

  • Rinsing and drying control

  • Powder manufacturer and product type

  • Color/RAL control

  • Electrostatic application and earthing

  • Coating coverage on edges, holes and weld zones

  • Oven temperature and curing time

  • Cure verification method

  • Film-thickness measurement

  • Adhesion and appearance inspection

  • Handling and packing after coating

Typical factory checks may include dry film thickness, color comparison, cross-cut adhesion, impact or bend performance, depending on the agreed specification.

If salt-spray evidence is requested, confirm the exact procedure, specimen preparation, exposure time and acceptance criteria. ISO 9227:2022 defines salt-spray test methods, but it does not prescribe one universal exposure period or convert test hours into years of real service. ISO also notes that these methods are not intended to rank materials generally or predict long-term corrosion resistance. The result must be interpreted against the agreed product specification and environment.

For coastal, humid, refrigerated, outdoor or chemically aggressive locations, tell the manufacturer before quotation. Standard indoor powder-coated shelving may not be the correct finish.

9. Review Incoming, In-Process and Final Inspection

Ask the quality team to show how defects are prevented and detected at each stage.

Incoming Inspection

  • Steel grade, thickness, width and batch identification

  • Powder and chemical identification

  • Purchased fasteners, feet, locks and accessories

  • Subcontracted parts or processes

In-Process Inspection

  • First-piece approval after machine setup

  • Profile and hole dimensions

  • Cutting length and bending angles

  • Weld location and appearance

  • Coating process parameters

  • Color and film thickness

Final Inspection

  • Overall dimensions

  • Quantity and component completeness

  • Fit and trial assembly

  • Surface finish and visible defects

  • Labels and markings

  • Packaging and carton/pallet condition

  • Order-specific documents

For lot-by-lot inspection, buyers may use a defined sampling plan. ISO 2859-1:2026 provides an acceptance-sampling system for inspection by attributes. The buyer and supplier must still agree on inspection level, lot definition, AQL values and the classification of critical, major and minor defects. “AQL inspection” without those details is not a complete inspection instruction.

Check Measurement-System Control

Review calibration or verification records for instruments such as:

  • Micrometers and calipers

  • Coating-thickness gauges

  • Scales and test weights

  • Tape measures and angle gauges

  • Load-test sensors or displacement devices

  • Oven temperature recorders

An inspector cannot create reliable data with unverified equipment.

10. Check Traceability and Nonconformity Control

Choose one finished unit or packed order and ask the factory to trace it backward.

A mature system should be able to identify, as applicable:

  • Sales order and approved specification

  • Drawing and BOM revision

  • Production order

  • Material batch

  • Operators or production shift

  • Inspection records

  • Coating batch or date

  • Final release

  • Packaging batch and shipping marks

Then review an actual nonconformity. Ask:

  • How was the problem identified?

  • How was affected material isolated?

  • Who approved rework, concession or scrap?

  • Was the customer informed when required?

  • What corrective action prevented recurrence?

A factory with no recorded defects may have a weak reporting culture rather than perfect production.

11. Verify Capacity, Lead Time and Supply-Chain Resilience

Machine count alone does not prove available capacity. Compare the promised lead time with real output, current workload and bottlenecks.

Request:

  • Recent monthly production records for comparable shelving

  • Current production schedule and order backlog

  • Output per shift for critical processes

  • Number of shifts and trained operators

  • Powder-coating line capacity

  • Tooling availability for the quoted profiles

  • Raw-material lead time

  • Planned subcontracting

  • Peak-season capacity and maintenance plan

  • Contingency for machine failure or material delay

Calculate capacity using the slowest critical process, not the fastest machine. Powder coating, welding, shelf-panel forming, special tooling or packaging may be the true bottleneck.

If the supplier promises an unusually short lead time, ask for a dated production plan showing material arrival, first-piece approval, manufacturing, inspection, packing and shipment readiness.

12. Audit Packaging and Container Loading

Steel shelving can pass factory inspection and still arrive damaged or incomplete if packaging is weak.

Inspect a packed set and confirm:

  • Number of components per carton or bundle

  • Protection between coated surfaces

  • Edge and corner protection

  • Control of movement inside the package

  • Moisture protection appropriate to the shipping route

  • Fastener and accessory kit identification

  • Carton strength and closures

  • Pallet structure and strapping where used

  • Shipping marks, model, quantity and package number

  • Assembly instructions and load labels

  • Barcode or private-label requirements

  • Gross/net weight and package dimensions

Compare the packing list with a physical pack-out. For mixed models, the package numbering system should allow the buyer to identify each bay and accessory without opening every carton.

Also review the proposed container-loading plan:

  • Confirm that the CBM calculation uses actual packed dimensions.

  • Check weight distribution and container payload limits.

  • Protect coated products from bands, forklift forks and container walls.

  • Confirm how packages will be unloaded at destination.

  • Request loading photographs and a final container checklist.

The cheapest package is not economical if it causes scratches, missing parts, repacking labor or customer claims.

13. Conduct a Sample or Pilot-Order Verification

A showroom sample proves only that one sample exists. Before a large private-label or project order, use a sample or pilot batch to confirm:

  • Dimensions and clear storage space

  • Component thickness and weight

  • Assembly time and instructions

  • Connector fit and adjustability

  • Surface finish and color

  • Load-test plan or evidence

  • Packaging method

  • Branding and labels

  • Compatibility with the buyer's cartons, bins or accessories

Keep one approved reference sample, or create a signed specification record with photographs and measured data. Mass production should be inspected against that controlled reference, not against memory.

14. Use Independent Inspection When the Risk Justifies It

A buyer does not always need a third-party auditor, but independent verification is valuable when:

  • The supplier is new.

  • The order value is high.

  • The product is customized.

  • Load capacity is safety-critical.

  • Local compliance documents are required.

  • The buyer cannot visit the factory.

  • The shipment has little tolerance for delay or rework.

Possible control points include:

  • Initial factory audit

  • Pre-production meeting

  • First-article inspection

  • During-production inspection

  • Witnessed load test

  • Pre-shipment inspection

  • Container-loading supervision

The inspection agency should receive the approved drawing, defect criteria, sampling plan, packing specification and test requirements. Asking an inspector to “check quality” without a technical checklist produces subjective results.

Suggested 100-Point Steel Shelving Factory Audit Scorecard

The following is a practical KAYOU editorial framework, not an official certification standard. Buyers should adjust the weightings to their project risk.

Audit AreaPointsWhat Good Evidence Looks Like
Legal identity and factory relationship10Verified entity, transparent manufacturing/export roles and matching records
Engineering and specification control15Controlled drawings, BOM, load definition, revision history and competent technical explanation
Material control and traceability15Verified steel grade/thickness, batch linkage, incoming inspection and calibrated measurements
Production-process capability15Suitable equipment, controlled forming/welding/coating, first-piece approval and stable workmanship
Load-capacity evidence15Model-specific method, configuration, loading diagram, measurements and acceptance criteria
Surface finish and corrosion protection10Controlled pretreatment, powder, curing, thickness, adhesion and relevant test evidence
Quality control and calibration10Incoming, in-process and final records; sampling plan; NCR/CAPA; verified instruments
Packaging and export readiness5Approved pack-out, component control, protective packaging and accurate loading plan
Capacity and delivery control5Evidence-based output, realistic schedule, bottleneck awareness and contingency planning
Total100

A buyer might classify the result as:

  • 85–100: Approved, subject to closing any project-specific actions

  • 70–84: Conditionally approved with corrective actions and follow-up evidence

  • Below 70: Not approved until major risks are corrected and re-audited

Do not let a high total score hide a critical failure. Falsified records, untraceable material, unsafe structural claims or refusal to permit agreed verification should be treated as stop conditions regardless of the total.

15 Red Flags When Auditing a Shelving Supplier

  1. The factory name does not match the quotation, certificate or payment beneficiary.

  2. Production areas are unavailable without a credible reason.

  3. The supplier cannot produce a controlled drawing or BOM for the quoted model.

  4. Steel thickness changes between the quotation, sample and production record.

  5. An MTC cannot be linked to the current material batch.

  6. Load capacity is advertised without UDL, span or structural details.

  7. The load report is for a different size, model or product category.

  8. ISO certification is presented as product load certification.

  9. Salt-spray hours are marketed as a guaranteed number of outdoor service years.

  10. Coating or welding is outsourced but the subcontractor is not controlled.

  11. Measuring instruments have no current calibration or verification record.

  12. The factory records no nonconformities, rework or corrective actions.

  13. Trial assembly requires grinding, hammering or unapproved modification.

  14. Packaging quantities are estimated rather than verified through a pack-out.

  15. Price and lead time are unusually low, but the supplier cannot explain how they are achieved.

How to Conduct a Remote Factory Audit

If an on-site visit is not possible, a structured remote audit is more useful than a polished factory video.

Ask for a live video session with a pre-agreed route:

  1. Show the exterior, company sign and current date/time reference.

  2. Move from raw-material storage through each production process.

  3. Select a random coil, component or production order.

  4. Show the drawing and BOM for that order.

  5. Measure critical component dimensions and thickness live.

  6. Show coating controls, quality records and instrument status.

  7. Assemble randomly selected parts.

  8. Inspect a packed set and shipping marks.

  9. Review records by screen share or close camera view, protecting unrelated customer data.

Follow the remote audit with an independent pre-shipment inspection if the order risk is significant. A live audit can verify capability; it does not replace shipment-specific product inspection.

Documents to Request Before Approving a Manufacturer

Send this checklist before the audit so the supplier has time to prepare original, relevant records:

  • Business licence and company details

  • Factory address and organization chart

  • Quality-system certificates and verification links

  • Product catalogue limited to relevant products

  • Approved technical data sheet

  • General assembly and component drawings

  • BOM with steel grade, profile and thickness

  • Material certificate sample and traceability method

  • Process flow chart

  • Incoming, in-process and final inspection samples

  • Equipment and calibration list

  • Load-test report or proposed test plan

  • Coating specification and related test evidence

  • Assembly instructions and SWL/load-label sample

  • Packaging specification and container-loading plan

  • Production-capacity and lead-time plan

  • Recent nonconformity/corrective-action example with customer data removed

The objective is not to collect the largest possible PDF folder. It is to verify that the documents agree with each other and with the factory floor.

Frequently Asked Questions

Is ISO 9001 enough to approve a steel shelving manufacturer?

No. ISO 9001 concerns the quality management system. It can support supplier confidence, but it does not prove the capacity, dimensions, steel thickness or corrosion performance of a specific shelving model. Product-specific technical evidence and inspection are still required.

How can I tell whether a Chinese supplier is a manufacturer or a trading company?

Check the Chinese legal entity, registered and factory addresses, production equipment, employees, material records and production orders. If a separate trading company handles export, ask for documented evidence of its relationship with the manufacturing entity. Transparency matters more than the label alone.

What is the most important physical measurement during a shelving audit?

There is no single measurement, but component thickness, profile geometry, clear span and reinforcement should be high priorities because they directly affect the structure and are often hidden by product names. Measurements must be compared with an approved drawing and tolerance.

How do I verify a shelf load rating?

Request a report or engineering basis that identifies the exact model, dimensions, span, material, component thickness, shelf configuration, load distribution, test method, measurements and acceptance criteria. For a custom order, approve a model-specific load-test plan and use independent witnessing when justified.

Should the proof load be 1.5 times the rated load?

Do not apply a universal multiplier without reference to the applicable standard, design method and product scope. Proof-load factor, duration and acceptance criteria should be defined by a qualified engineer or the agreed test standard for the specific shelving system and destination market.

What AQL should I use for shelving inspection?

There is no universal AQL that suits every order. Define critical, major and minor defects based on product and safety risk, then agree on the lot, inspection level, sampling plan and acceptance limits. Structural mismatch, missing safety components or false load labels may require stricter treatment than minor cosmetic marks.

Can a remote audit replace an on-site audit?

A live remote audit can verify many documents, measurements and processes, especially when combined with a third-party pre-shipment inspection. It is less effective for judging factory scale, process consistency and subtle production conditions. Use a risk-based combination of remote, on-site and shipment-specific controls.

When should I audit the powder-coating subcontractor?

Audit or independently verify the coating source when finish performance is critical, the environment is corrosive, order volume is high or the shelving manufacturer cannot demonstrate adequate incoming control of coated parts. The subcontractor's process should be part of the approved supply chain.

Is the lowest-priced shelving supplier usually the highest risk?

Not always. Efficient design, high-volume production and optimized packaging can reduce legitimate cost. The risk appears when a low price depends on unspecified steel thickness, reduced reinforcement, unverified load claims, weak coating or incomplete packaging. Ask the supplier to explain the cost difference through measurable specifications.

What should I inspect before paying the balance?

Inspect quantity, dimensions, component thickness, assembly fit, finish, labels, packaging, documentation and any agreed performance tests using the approved specification. Confirm corrective actions before shipment and include container-loading verification where necessary.

How KAYOU Supports Buyer Factory Audits

KAYOU manufactures customizable steel shelving and warehouse storage products in Luoyang, China for distributors, project contractors, wholesalers and commercial buyers. We believe supplier qualification should be based on clear specifications and verifiable production evidence.

Depending on the product and project requirements, buyers can request:

  • Technical specification and configuration confirmation

  • Product and component drawings

  • Steel thickness and material information

  • Sample or pilot-order review

  • Load-test planning and available supporting records

  • Production and quality-control review

  • Packaging and container-loading information

  • Live factory communication or on-site buyer inspection

  • Coordination with an independent inspection company

Learn more about the KAYOU steel shelving factory, our manufacturing process and quality control.

If you are sourcing medium duty steel shelving, long span shelving or a customized warehouse storage solution, send us the required size, load per level, shelf count, quantity, destination and use environment. Our team will prepare a configuration and quotation for technical review.

Audit the Evidence, Not Just the Factory Appearance

A professional factory audit should leave the buyer with a connected evidence chain:

Requirement → Drawing and BOM → Material → Production → Test/Inspection → Packaging → Shipment

The strongest steel shelving manufacturer is not necessarily the one with the largest showroom or the most certificates. It is the supplier that can explain its technical decisions, permit relevant measurements, control repeat production, identify problems honestly and deliver traceable evidence that the finished order matches the approved specification.

Need to Audit or Source a Steel Shelving Manufacturer in China?

Tell KAYOU your shelving dimensions, rated load, number of levels, order quantity, destination market and audit requirements. We can prepare the technical information needed for your supplier review and quotation.

Contact KAYOU for a Steel Shelving Solution

WhatsApp: +86 158 3799 8881

Technical References

Share:
Anna Liu

Anna Liu

Storage Solution Consultant

8+ years in steel shelving, pallet racking and mobile shelving projects.

Free Layout Design

Tailored layouts to fit your space

Fast Quotation

Quick response within 24 hours

OEM/ODM Support

Custom sizes, colors & branding

Related Posts news
